Whole House Renovation Cost: Budget, Breakdown, Tips

You know your home needs a complete overhaul, but every contractor gives you a different number.

One quote seems impossibly low, another makes you question whether you can afford this at all, and a third falls somewhere in between with vague explanations about “scope” and “contingencies.”

The confusion leads to anxiety, and the anxiety leads to paralysis, or worse, starting a project without truly understanding what you’re paying for.

The challenge isn’t just getting quotes. It’s knowing whether those quotes make sense for what you actually need.

You need to understand what drives costs up or down, which expenses you can control, and where you should expect to spend more.

What a Whole House Renovation Actually Includes

A complete home renovation updates most systems and surfaces in your house. Contractors usually price the work in parts, but complete it in planned phases.

It starts with planning and design, including measurements, drawings, and choosing materials. Next comes demolition and site prep. Then structural repairs may be done to framing, walls, beams, or subfloors.

After that, major systems are updated: electrical, plumbing, and HVAC, including panels, lines, and fixtures. The exterior “shell” may also be improved with windows, doors, insulation, or roof repairs.

Inside, crews finish drywall, floors, paint, trim, doors, and lighting. Kitchens and bathrooms often need extra work. Final steps include inspections, cleanup, and punch-list fixes.

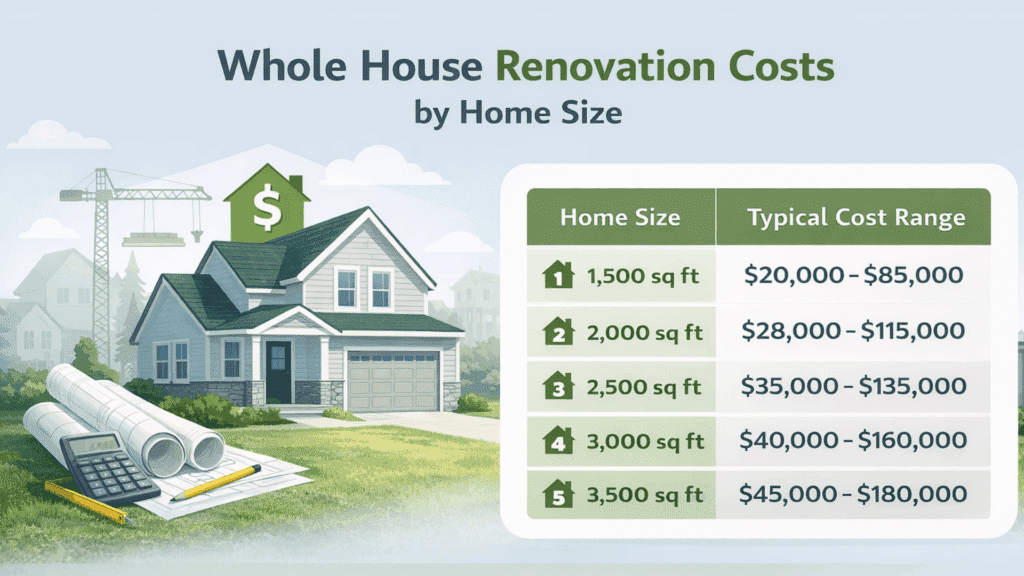

Whole House Renovation Cost by Home Size

whole house renovation cost

The size of your home directly impacts total cost, though per-square-foot rates drop slightly as projects scale up due to efficiencies in labor and material ordering.

Most homeowners spend between $15 and $150 per square foot on whole-house renovations, with typical projects ranging from $30,000 to $200,000 depending on scope and home size.

Projects involving gut renovations with layout changes, relocated plumbing, or upgraded electrical service land above these ranges. Full gut work runs $60 to $150 per square foot, reflecting the complexity of tearing down to studs and rebuilding with modern systems and finishes.

Complete Budget Breakdown for a Whole House Project

Think of your total budget as a pie that gets divided across major categories. Understanding these proportions helps you allocate funds realistically and spot quotes that don’t align with typical spending patterns.

Structure and systems (30-40% of total)
Foundation, framing, electrical, plumbing, HVAC. This is your home’s infrastructure—the work you won’t see but can’t skip.

Kitchen (20-30% of total)
Cabinets, countertops, appliances, plumbing, and electrical. Kitchens demand the highest per-square-foot investment in any renovation.

Bathrooms (15-20% of total)
Fixtures, tile, vanities, plumbing. Multiply by the number of bathrooms you’re renovating.

Finishes throughout (20-25% of total)
Flooring, paint, trim, doors, and lighting. This covers all living spaces, bedrooms, and hallways.

Contingency (10-20% of total)
Your safety net for surprises behind walls. Older homes need the higher percentage.

Sample Budget Calculator

For a 2,000 sq ft home at $80 per square foot (mid-range renovation):

Total project cost: $160,000

  • Structure and systems: $56,000 (35%)
  • Kitchen: $40,000 (25%)
  • Bathrooms (2): $28,000 (17.5%)
  • Finishes: $20,000 (12.5%)
  • Contingency: $16,000 (10%)

Adjust percentages based on your priorities, but keep kitchen and bathroom costs realistic. They rarely come in under budget.

Note: Keep a Contigency buffer of 10% to 20% of total project cost. Older homes with unknown conditions behind walls need contingency toward the higher end. This covers surprises like outdated wiring, hidden water damage, or code compliance upgrades discovered during work.

Room-by-Room Cost Expectations

Not all rooms cost the same to renovate. Kitchens and bathrooms demand the most budget, while living spaces and bedrooms cost significantly less for similar square footage.

1. Kitchens

kitchen renovation cost

Kitchens consume disproportionate budget shares due to their complexity. These rooms often run $100 to $250 per square foot when you factor in cabinetry, plumbing fixtures, tile work, and appliances.

A 150-square-foot kitchen can easily hit $30,000 to $40,000 for a mid-range renovation.

2. Bathrooms

bathroom renovation cost

Bathrooms follow similar patterns to kitchens with specialized plumbing, tile work, and moisture-resistant materials, driving costs higher.

Expect to spend comparable per-square-foot rates, though the smaller size keeps total costs lower than kitchen renovations.

3. Living Spaces, Bedrooms, and Hallways

bedroom renovation cost

These areas cost significantly less when you’re doing cosmetic updates. New paint, flooring, trim, and lighting typically run $15 to $40 per square foot.

The price increases when you’re moving walls, adding built-ins, or upgrading electrical capacity for modern lighting and technology needs.

4. Exterior Work

exterior renovation cost

Roof replacement, window upgrades, and siding often get overlooked in whole-house budgets. A roof replacement alone runs $5,000 to $15,000 for typical homes, while window replacement costs $500 to $1,200 per opening installed.

These elements matter for energy efficiency and long-term home performance, but don’t provide the immediate visual satisfaction of interior updates.

Hidden Costs That Catch Homeowners Off Guard

Permits, engineering fees, and inspection costs vary widely by location. Some municipalities charge flat fees while others calculate based on project value. Structural work requires engineer stamps in most jurisdictions, adding $1,000 to $3,000 to your budget.

Dumpster rental and debris removal for a whole house project runs $500 to $2,000, depending on volume and disposal fees in your area. Site protection, including dust barriers, floor covering, and equipment staging, adds another $500 to $1,500.

Temporary housing during construction forces many families into rental properties or extended hotel stays. A three-month gut renovation might require $3,000 to $9,000 in temporary housing costs. Storage units for furniture and belongings add $100 to $300 monthly.

Hazardous material testing and removal apply to homes built before 1980.

Lead paint and asbestos testing costs $300 to $800, while remediation runs $1,500 to $3,50,0, depending on the extent of contamination. Skipping this step creates health risks and legal liability.

Building Your Renovation Budget in Four Steps

Creating an accurate budget requires more than guessing at a total number. Follow these four steps to build a renovation budget that accounts for your specific home and project scope.

Step 1: Measure Your Finished Square Footage

Count only the areas you’re renovating. Unfinished basements and garages don’t factor into whole-house pricing unless you’re converting them to living space.

Step 2: Choose Your Scope Band Based on Project Intensity

Cosmetic updates with new finishes and fixtures fall into the $15 to $60 per square foot range. Full gut renovations requiring system replacements and layout changes run $60 to $150 per square foot.

Multiply your square footage by your chosen rate to establish a baseline.

Step 3: Add Specific Allowances for Kitchens and Bathrooms

These rooms exceed whole-house averages. Budget $10,000 to $50,000 per kitchen and $5,000 to $25,000 per bathroom based on the quality level you’re targeting.

Step 4: Include Permits and Contingency in Your Final Number

Add permit costs based on local requirements, then calculate 10% to 20% of your total for contingency.

This buffer protects against surprises and prevents difficult decisions when contractors discover problems behind walls.

Your final budget should feel uncomfortable but manageable. If the number seems too easy, you’ve likely underestimated somewhere.

Return on Investment and Resale Value

Few home improvements return more than 100% of their cost at resale. The 2025 NAR remodeling impact report shows a new steel front door achieving 100% cost recovery, while most kitchen and bathroom projects return 50% to 75% of investment.

Market conditions and neighborhood comparables matter more than renovation quality in determining resale value.

Smart spending focuses on improvements that enhance livability for your timeline in the home while maintaining buyer appeal.

Kitchens and bathrooms deserve quality investment since they influence purchase decisions. Overly personal design choices or over-improving beyond neighborhood standards waste money that won’t return at sale.

Choose two or three areas to splurge on finishes while keeping the rest at builder-grade or mid-range quality.

Key Factors That Change Final Costs

factors affecting renovation cost

Your initial estimate can shift dramatically based on decisions you make and conditions contractors discover. Understanding these variables helps you anticipate where costs might climb and where you have control.

1. Layout Changes

Moving walls requires structural engineering, new framing, and rerouting of electrical and HVAC systems. A simple wall removal costs $1,500 to $3,000, while complex reconfigurations can add $10,000 to $25,000 to your project.

2. Plumbing and Electrical Upgrades

Relocating plumbing or upgrading electrical service creates major expenses. Moving a kitchen sink requires new drain lines and venting, adding $1,000 to $2,500.

Upgrading from 100-amp to 200-amp electrical service costs $2,000 to $4,000, including panel replacement and utility coordination.

3. Home Age and Hidden Damage

Older properties commonly expose outdated wiring, inadequate insulation, moisture damage, or structural settling that requires immediate attention once demolition begins.

These discoveries add 10% to 30% to initial estimates.

4. Material Grade Choices

Builder-grade fixtures and finishes might run $50 per square foot installed, while designer selections reach $150 per square foot for the same work.

Custom millwork, imported tile, and premium appliances double or triple baseline budgets.

Timeline Expectations and Planning Phases

Understanding how long each phase takes helps you plan temporary housing, coordinate schedules, and set realistic expectations with your family.

PhaseTimeline
Planning and design3–6 months
Cosmetic refresh construction3–5 months
Gut renovation construction8–12 months
Custom cabinetry lead time8–12 weeks
Window lead time6–10 weeks

Add extra time for inspection scheduling and supply chain delays on specialty items like custom doors and unique flooring materials.

Conclusion

You now have the framework to evaluate quotes confidently and build a realistic budget. The confusion that brought you here doesn’t have to follow you into contractor meetings.

You know what questions to ask, which costs to expect, and where surprises typically appear.

Most importantly, you understand that the right budget isn’t about finding the lowest number. It’s about knowing what you’re actually paying for.

What’s your biggest concern about your whole house renovation? Drop a comment below.
